How Long Does A Pool Renovation Take In Winnipeg? A Realistic Timeline For Homeowners

UV PoolsPool Renovations

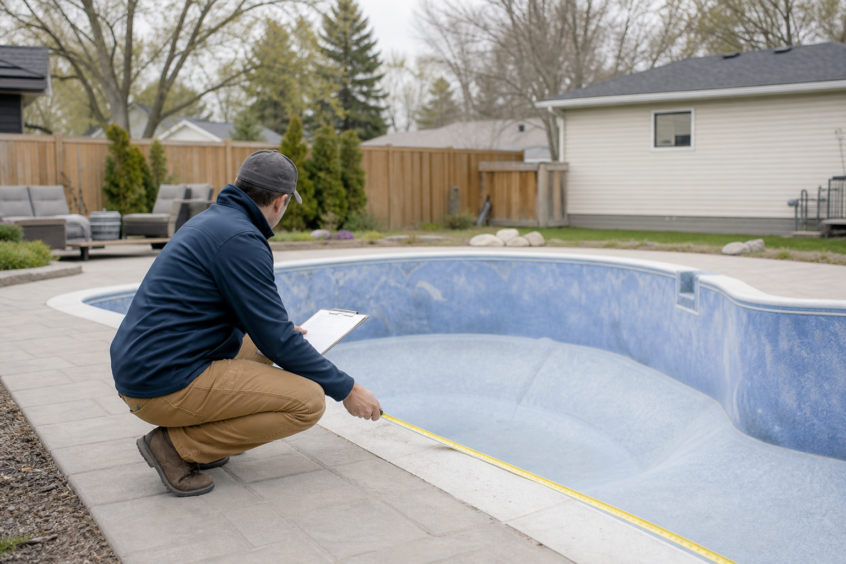

Pool technician measuring a drained backyard pool for renovation planning

A pool renovation takes anywhere from 1 to 2 weeks for a simple resurfacing, 3 to 6 weeks for a standard overhaul with new coping and equipment, and up to 2 to 3 months for complex luxury projects requiring structural repairs or new decking.

What Is The Typical Pool Renovation Timeline In Winnipeg?

Most homeowners need to think in two timelines: Booking time and work time. Most Winnipeg pool renovation projects take 1 to 3 weeks of active work, but total calendar time from first call to first swim is often 2 to 4 months in peak season.

Renovation Type Typical On-Site Time Total Project Time Pool Unusable/Drained Time
Pool liner replacement 3 to 5 working days 7 to 14 days 4 to 7 days
Pool coping replacement 3 to 14 days 1 to 3 weeks 5 to 14 days
Equipment upgrades for pool pump, pool filter, pool heater, or saltwater system 1 visit for install 1 to 4 weeks with ordering 0 to 2 days
Concrete pool resurfacing or acrylic resurfacing without structural repair 1 to 2 weeks 2 to 3 weeks 1 to 3 weeks
Structural crack repair 2 to 3 weeks Several weeks 2 to 4 weeks
Full renovation with pool decking and extras 4 to 8 weeks 1 to 3 months 4 to 10 weeks

The pool’s structural condition changes everything. A liner swap may be simple, but hidden leaks can damage pool plumbing, crack concrete, affect return lines and the main drain, and turn a repair into a larger renovation. If you’re considering pool renovations in Winnipeg, a professional inspection gives a far better timeline than a phone estimate.

What Affects How Long A Pool Renovation Takes?

Scope is the biggest factor. Minor repairs may take days, while resurfacing, steps, pool tile, lighting, plumbing changes, a hot tub addition, or excavation can push the job into weeks.

Hidden damage, weather, and contractor availability also matter. Winnipeg’s freeze-thaw cycle can reveal cracked skimmer lines, broken return lines, vinyl shrinkage, or settlement after opening, while weather delays can add days or weeks. A simple pool liner replacement may only need 5 days of labour but still take 6 to 10 weeks on the calendar if you book late; at UV Pools, project lead time is often 2 to 6 weeks in late winter, 4 to 8 weeks by March, and 8 to 12 weeks or more by June.

Permits and materials can add more time. Structural, electrical, and some plumbing changes may need permit approval or inspection.

A Step-By-Step Pool Renovation Process And Time Estimate

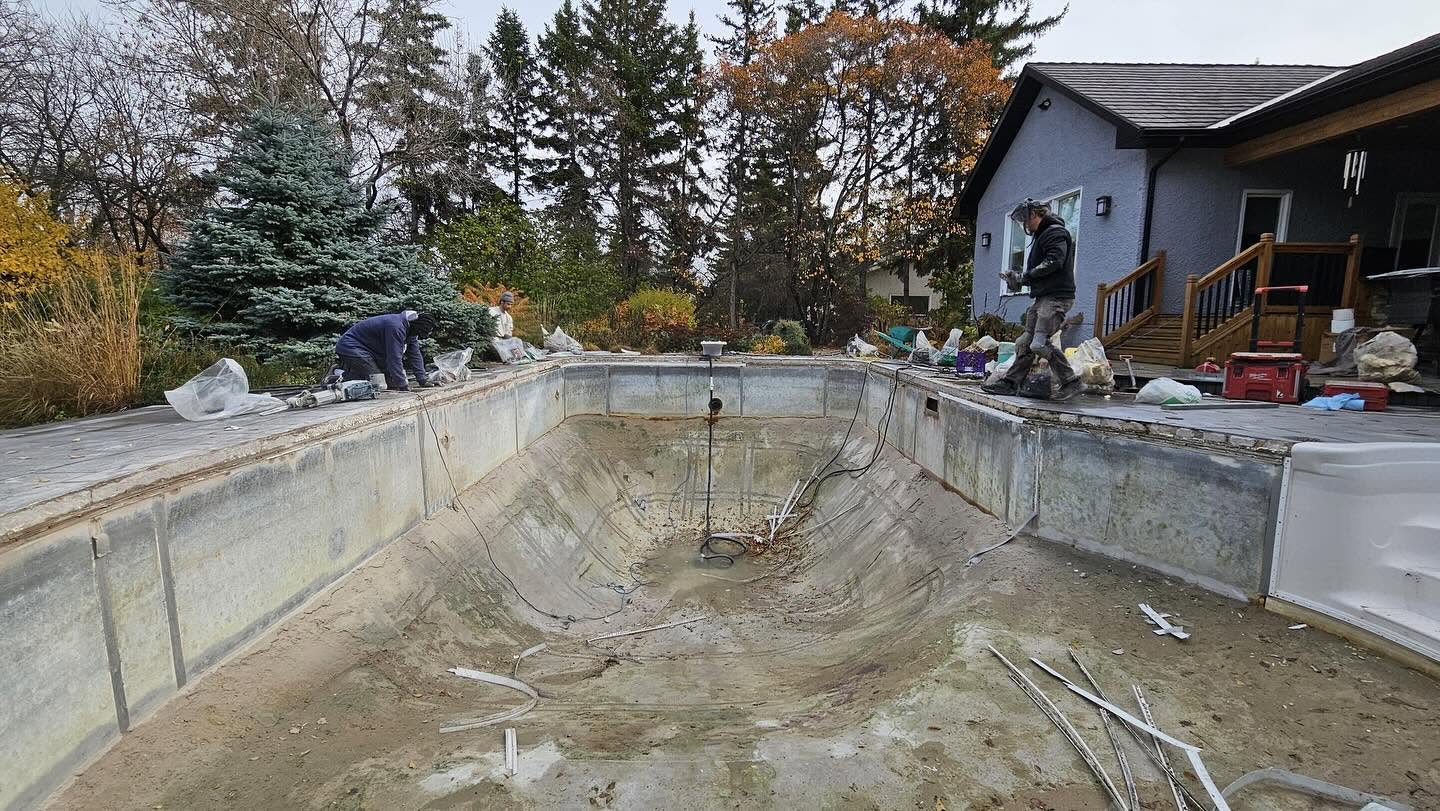

Workers renovating a drained backyard pool with the liner removed

At UV Pools, we follow a clear process, so homeowners know what happens before work starts and while the job is underway. Planning, ordering, scheduling, and inspections often take longer than the visible on-site labour:

Step 1: Inspection & Planning

This phase usually takes 1 to 3 weeks and covers consultation, budget, design choices, and permits. Estimates before opening are helpful, but the real timeline becomes clearer only after the pool is opened, drained, and inspected.

If you’re unsure whether your liner is nearing the end, our post on pool liner lifespan can help.

Step 2: Measuring, Ordering, & Scheduling

This stage usually takes 1 to 4 weeks after signing, though peak pool season can push it longer. Custom liners, natural stone, specialty pool coping, and some equipment parts are common sources of delay.

Bundling work such as liner replacement, pool plumbing, and coping repair can shorten the overall calendar if sequenced properly.

Step 3: Draining & Prep Work

Prep usually takes a few days to 1 week. This is when hidden issues often appear, such as corroded walls, deeper cracks, or problems tied to the main drain or buried return lines.

If you’ve noticed signs of a pool liner leak, this is often when the full cause becomes clear.

Before work begins, it helps to:

  • Call Manitoba Hydro and Gas Utilities for underground locates
  • Clear an 8-foot backyard access path
  • Remove furniture, planters, and loose items
  • Confirm gate width for equipment access
  • Drain the pool in advance if we’ve asked you to
  • Let us know if old deck sections, fences, or sheds affect access

Step 4: Repairs, Installation, & Construction

This is the main work phase and varies the most.

  • Pool liner replacement: 3 to 5 working days on-site
  • Concrete pool resurfacing and retiling: 1 to 2 weeks
  • Pool coping and waterline tile: 1 to 2 weeks
  • Structural crack repair: 2 to 3 weeks
  • Full pool decking renovation: 1 to 3 weeks
  • Full pool overhaul: 1 to 3 months

Your pool may stay drained longer than the crew is on-site because of curing, inspections, or sequencing. If you’re comparing finishes, rubber pool deck surfaces are one option, and if coping is failing with the liner, our article on pool liner coping repair explains why those issues often appear together.

Step 5: Filling, Testing, & Final Handoff

Finalization usually takes about 1 week, plus any curing time. We refill the pool, test circulation, check equipment, and confirm everything is working properly.

If you’re seeing wrinkles, lumps, or shifting in the vinyl, these common pool liner issues can signal problems that affect both timing and scope.

Renovated backyard swimming pool with blue water and a finished pool deck

Plan Your Winnipeg Pool Renovation With UV Pools

At UV Pools, we’re honest about timelines for pool renovations in Winnipeg because exact promises are impossible before we see the pool’s condition and full scope. Surface updates can move quickly, but structural repairs, electrical upgrades, permit approval, deck replacement, hidden damage, rain, and curing time all add days or weeks.

A simple update may take 2 to 3 weeks, while larger projects involving decking, plumbing, concrete, or fibreglass pool repair take much longer. If you want a summer liner project, call in February or March; for bigger renovations, late winter is even better. If you’re ready to picture a refreshed backyard with a realistic timeline behind it, contact us today at UV Pools.

Pool Renovation FAQs

How long does a pool liner replacement take in Winnipeg?

A pool liner replacement usually takes 3 to 5 working days on-site. Total project time is often 7 to 14 days once measuring, ordering, shipping, and installation are included.

Can weather delay a pool renovation project?

Yes. Rain slows curing, and liner or concrete work may need to pause in wet or cold conditions.

What time of year is best for pool renovations in Winnipeg?

Late winter and early spring are best for planning, and May through August is the main construction window. Major renovations are best underway before mid-August.

How far in advance should I book my pool renovation?

Book as early as possible. Late winter gives you the best chance of landing a pre-summer opening.

Do larger repairs make the renovation take much longer?

Yes. A simple resurfacing job may take 1 to 2 weeks, while structural repairs, plumbing damage, excavation, and deck replacement can push the project to 10 to 12 weeks or more on the calendar.

Can I use my pool right after the renovation is finished?

Not always. Some projects are ready soon after filling and testing, but new finishes may need curing time before regular swimming.
